Project Description
HEDLEY BATTERY ENERGY STORAGE SYSTEM (BESS) PROJECT by Hedley BESS LP
The Hedley Project will help power thousands of homes and businesses while delivering up to a total of 211 megawatts (MW) nameplate capacity of energy storage to enhance electricity reliability and meet grid demands.
Project Information: At Time of Engagement
The Hedley BESS Project, a 211MW energy storage facility, is designed to effectively store and provide energy to the grid as needed by the Independent Electricity System Operator (IESO). This project has a primary goal to assist the grid’s reliability by storing energy during periods of low-demand and releasing it during peak demand, ensuring a consistent power supply.
- The project was selected by the IESO under the Long Term 1 (LT1) procurement, at the direction of the Ministry of Energy, as part of the largest energy storage procurement in Ontario’s history.
- The Hedley BESS Project is named after the Hedley Forest, a prominent natural feature local to Haldimand County.
- BESS facilities help deliver energy efficiently and will be one of the key technologies to decarbonizing Ontario’s energy supply as well as meeting future clean energy demand.
- Aypa Power puts safety first, advancing a layered fire safety approach and meeting all local, national and international safety codes and standards
- Technical environmental assessments are currently underway and must meet Ontario standards for permitting approval.
- The chosen EPC contractor will use commercially reasonable efforts to hire qualified Indigenous applicants who meet the job qualifications and experience required and engage Indigenous-owned businesses like A6N for project-related services.
Project Timeline
- November 2023
- IESO released the RFP for Long Term Reliability Services
- December 2023
- Secured SNGRDC shareholder support to submit bid
- December 2023
- Proposal submission to IESO
- May 2024
- IESO announced successful bids
- June 2024
- SNGRDC and Aypa Power executed definitive agreements
- July 2024 – August 2024
- Six Nations Community Investment Review period
- June 2024 – April 2027
- Completion of technical studies and construction
- Hedley Archeology Assessment Stage 1-2 and Stage 3 – in progress, target completion by October 31, 2024
- Hedley Cultural Heritage Assessment – in progress, target completion by November 30, 2024
- Hedley Noise Impact Assessment – plan to commence by October 31, 2024
- Hedley Natural Heritage Assessment – completed
- May 2027
- Hedley Project expects to be commercially operational

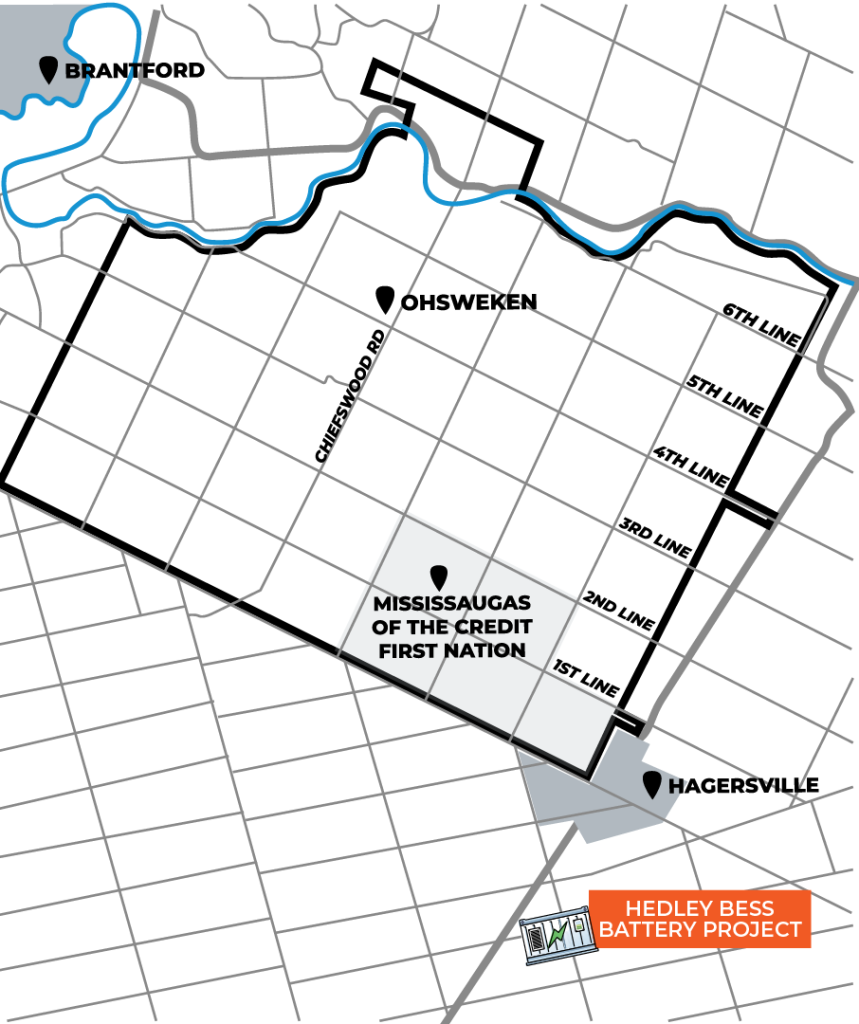

Project Location
- The Hedley BESS Project is located in Haldimand County outside of Hagersville
- Nearest intersection is Concession 9 Walpole & Yule Road., Jarvis, ON
- The project is not in the Haldimand Tract
Community Engagement Timeline
- July 2, 2024 – Initial Release of Information via www.snfuture.ca
- July 2, 2024 – Community Commentary period opens
- July 20, 2024 – Community Investment Review
- July 25, 2024 – Community Investment Review
- August 9, 2024 – Community Commentary period closes
Community members are invited to submit their online comments via the SN Future Platform, via email at [email protected] or during our Community Investment Reviewom
Community Investment Review Dates
Saturday, July 20 – 10:00am-1:00pm
Thursday, July 25 – 5:00pm-8:00pm
Project Highlights and Community Benefit Structure
- On average will yield $1.2 million annually for the Six Nations Community*
- Construction phase will create 200-300 jobs with a focus on local employment
- Reduce approximately 1.8-2.45 million tonnes of carbon emissions*
- Six Nations archeological monitors have been engaged and have been on site
- $500,000 commitment to Grand River Post Secondary Education Office*
- Will offer substantial savings to Ontario ratepayers*
*Over the 20-year contract
